A General Plan Amendment is any change to the Town's voter-ratified General Plan that occurs between Comprehensive Plan updates. These requests most often concern changes to the Town’s Land Use Map and generate a significant amount of interest within the community. There are two types of General Plan Amendments, which are reviewed for conformance to the criteria found in Section 22.2 of the Zoning Code.
General Plan Amendment applications require consideration by the Planning and Zoning Commission (PZC) and approval by Town Council. The following items must be submitted online for staff review, prior to scheduling the public hearings. Applicants are encouraged to process the General Plan Amendment application concurrently with any associated Rezoning to minimize project timelines.
As specified in the Oro Valley Zoning Code, all fees must be paid in full prior to approval of an application.
Public outreach: The cost for mailing postcards for the neighborhood meeting(s) will be added to the pre-application via the Town’s online permitting system.
The following is a list of fees associated with General Plan Amendments.
The actual processing time is dependent upon timely and complete applicant submittals.
The review process for Type 1 General Plan Amendment typically takes between 30-32 weeks.

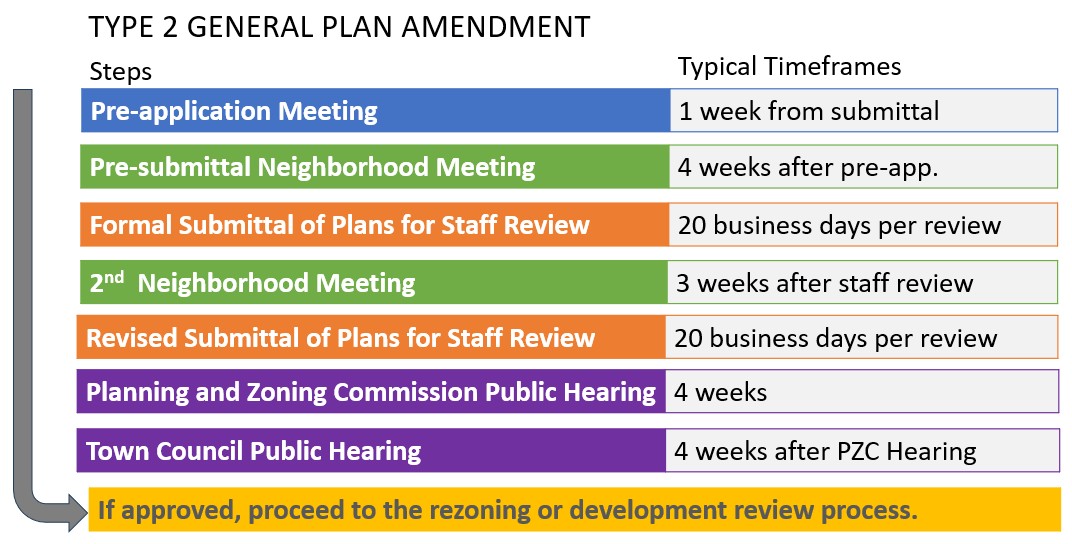

The review process for Type 2 General Plan Amendment typically takes between 28-30 weeks.
Applicants are encouraged to process the General Plan Amendment application concurrently with any associated Rezoning to minimize project timelines.
STANDARD REVIEW PROCESS
(Submitting sequentially)

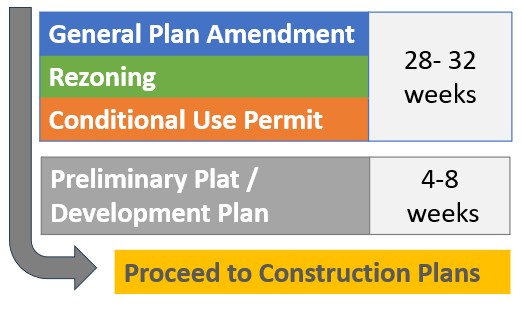

CONCURRENT REVIEW PROCESS
(Submitting together)
Total process time to construction plans:
76 - 92 weeks (19 - 23 months)
36 - 44 weeks (9 - 11 months)
Step 1: Pre-application
The more information you are able to provide the more feedback staff will be able to give.
As part of the Public Outreach process (Section 22.15.E of the Zoning Code), the Public Outreach Plan and subsequent report are required.
Please note, the Public Outreach Report must be updated and resubmitted throughout the process accordingly.
A 1–2-page project fact sheet is required, prior to the neighborhood meetings. The fact sheet should provide details about the proposed development, including, but not limited to:
The project fact sheet will be posted online and distributed during the neighborhood meeting(s).
Type 1 General Plan Amendments involve significant changes to the Town's General Plan. Type 1 General Plan Amendments are defined in Section 22.C of the Zoning Code.
Type 1 General Plan Amendments involve changes with less impact to the Town's General Plan. Type 2 General Plan Amendments are defined in Section 22.C of the Zoning Code.
